Dickerage Lane Elastomac Repair

Permanent Highway Reinstatement

Download PDF

Summary: When a water leak closed a busy Kingston bus route, we redirected an Elastomac crew at short notice and completed 176 m² of permanent repairs in one shift.

176 m²permanent repairs
One shiftdelivery
Short noticecrew redirected
19 monthsfollow-up evidence

The challenge

Dickerage Lane is normally a main bus corridor where closures are difficult to get. A water leak created an unexpected closure – a short window to carry out maintenance that would otherwise need complex traffic management.

The solution

Platinum 3Sixty redirected its crew and deployed Roadmender Elastomac to deliver permanent repairs within the available closure. Defects were cleaned and prepared for a strong bond, then the Elastomac was heated in the boiler, applied directly to the defects and finished flush with the surrounding asphalt.

The rapid installation meant 176 m² of permanent repairs were completed in a single shift, restoring the road surface with minimal disruption to traffic and public transport.

Results

Rather than wait for a separate planned closure, the team made the most of an existing one and returned the route to normal service in the same window.

19 months on: still in service

Photos taken 19 months after the January 2025 repairs show the treated areas still visible and in service, with no wholesale breakdown of the repaired section.

Innovative maintenance can reduce repeat disruption by making better use of scarce closure opportunities – here, a closure caused by an unrelated utility issue.

Frequently asked questions

Where was this elastomac permanent repair carried out?

Dickerage Lane, Kingston upon Thames, London, for Local authority highways.

How long did the works take?

One shift.

Why was this method used?

Platinum 3Sixty redirected its crew and deployed Roadmender Elastomac to deliver permanent repairs within the available closure. Defects were cleaned and prepared for a strong bond, then the Elastomac was heated in the boiler, applied directly to the defects and finished flush with the surrounding asphalt.

What was the result?

Rather than wait for a separate planned closure, the team made the most of an existing one and returned the route to normal service in the same window.

Has the repair lasted?

Photos taken 19 months after the January 2025 repairs show the treated areas still visible and in service, with no wholesale breakdown of the repaired section.

Related: Elastomac permanent repairs · Climate funding guide · All case studies

Full case study (PDF)

Project Overview

Platinum 3Sixty completed permanent Elastomac repair works at Dickerage Lane, delivering a durable and low-carbon highway reinstatement solution designed for long-term performance.

The project focused on reducing repeat maintenance requirements while minimising disruption to road users through efficient installation and rapid curing.

Key Benefits

Permanent Repair

Long-life Elastomac reinstatement reducing repeat maintenance.

Low Carbon

Reduced environmental impact compared to traditional throw-and-go repairs.

Rapid Installation

Fast-curing repair system minimising road closure durations.

Zero Waste

Efficient repair process helping reduce waste and unnecessary material use.

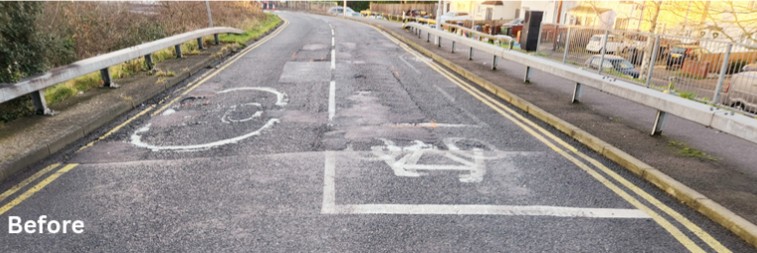

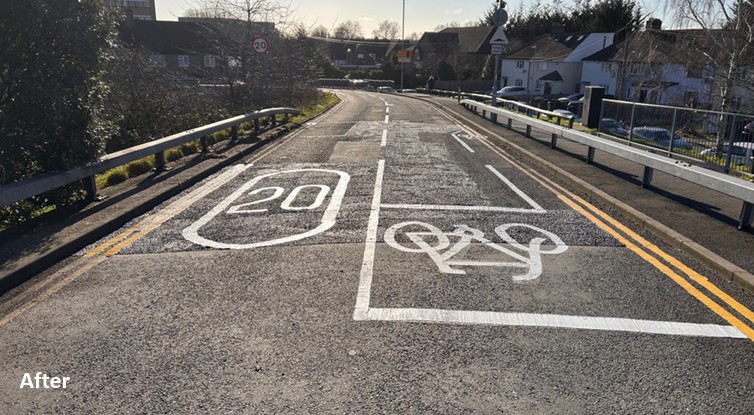

Before & After

Full Case Study PDF
