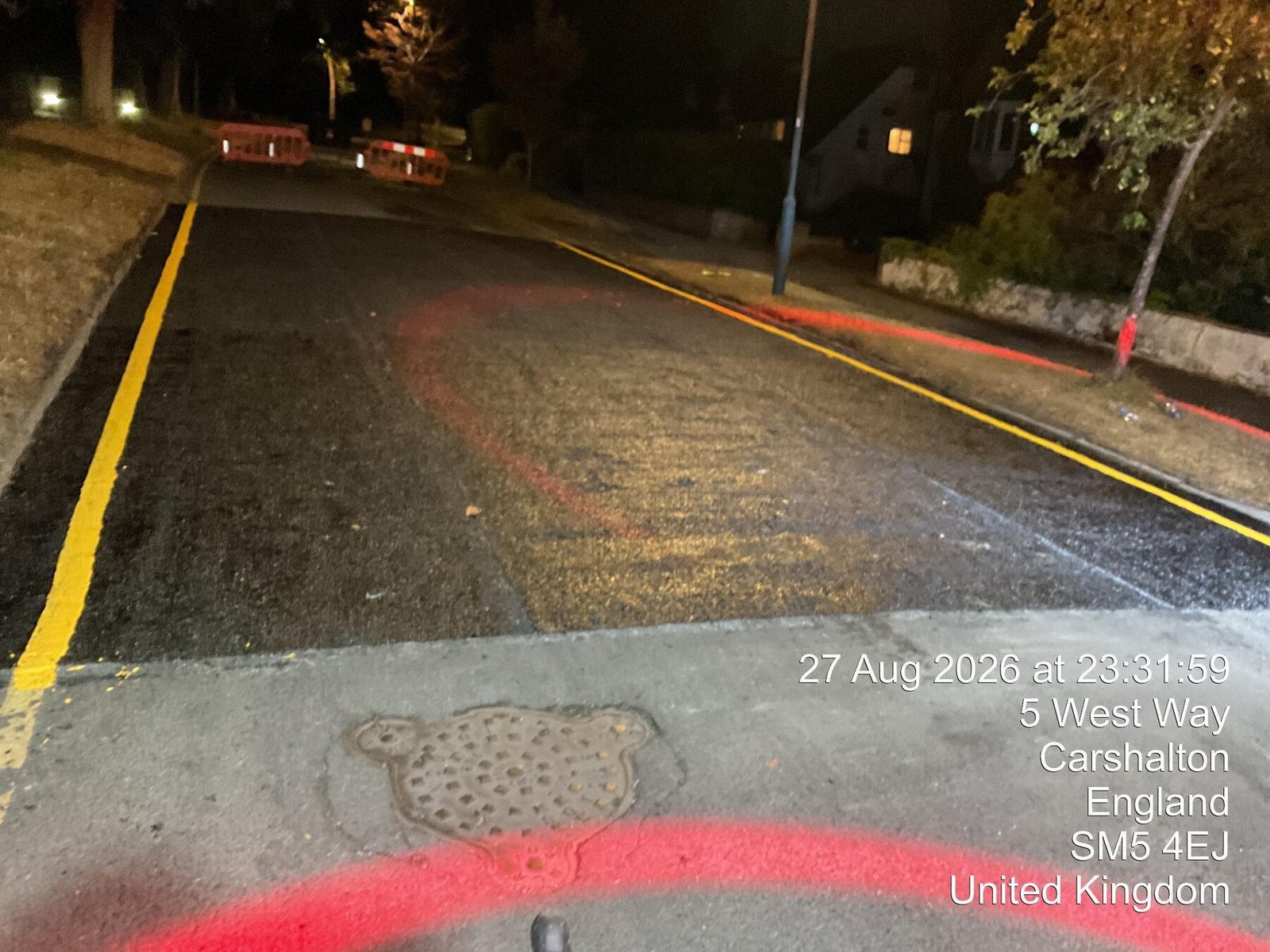

Completed Elastomac carriageway repair at West Way Sutton during overnight works

Elastomac Road Repair - West Way, Sutton

Approximately 126 m² of Elastomac Carriageway Repair in a Single Overnight Working Window

Download Case Study PDF

Summary: Localised carriageway deterioration and failed patches on West Way repaired with Elastomac in a single overnight window, side by side.

126 m²Elastomac repair
1 nightdelivery
15 minto trafficable
27 Aug 2026works date

The challenge

West Way had worn surfacing, previous patching and localised defects across the full width of the carriageway. A conventional full-width repair would normally need two traffic-management set-ups, one for each side.

The solution

Elastomac's rapid cure let the team switch traffic management from one side of the carriageway to the other, completing the full-width repair in a single night.

Repaired areas were trafficable within 15 minutes, which avoided a second set-up and kept disruption to a minimum.

Results

A clean, finished carriageway in one overnight window instead of two.

Frequently asked questions

Where was this elastomac road repair carried out?

West Way, Carshalton, London Borough of Sutton, for Local authority.

How long did the works take?

One night.

Why was this method used?

Elastomac's rapid cure let the team switch traffic management from one side of the carriageway to the other, completing the full-width repair in a single night.

What was the result?

A clean, finished carriageway in one overnight window instead of two.

Related: Elastomac permanent repairs · Climate funding guide · All case studies

Full case study (PDF)

Project Overview

Approximately 126 m² of Elastomac carriageway repair was completed for a local authority during a single overnight working window.

Worn surfacing, previous patching and localised defects were repaired in a single overnight working window, leaving a clean finished carriageway surface.

126 m²Elastomac repair
1 nightDelivery window
27 Aug 2026Works date
Local authorityClient

The Problem: Localised Deterioration & Existing Patch Failures

The primary issue was localised carriageway deterioration and existing patch failures. The existing carriageway showed worn surfacing, previous patching and localised defects.

Full-Width Repair in a Single Overnight Shift

Elastomac’s rapid cure allowed the team to switch traffic management from one side of the carriageway to the other, completing the full-width repair in a single night.

This avoided a second TM setup and kept disruption to a minimum, with repaired areas trafficable in approximately 10 minutes.

1 Night Delivery Window

Approximately 126 m² of Elastomac carriageway repair was completed during a single overnight working window.

Full-Width Repair in One Shift

Traffic management was switched from one side of the carriageway to the other, completing the full-width repair in a single night.

Rapid Cure

Repaired areas were trafficable in approximately 10 minutes.

Reduced Disruption

The single-night approach avoided a second TM setup and kept disruption to a minimum.

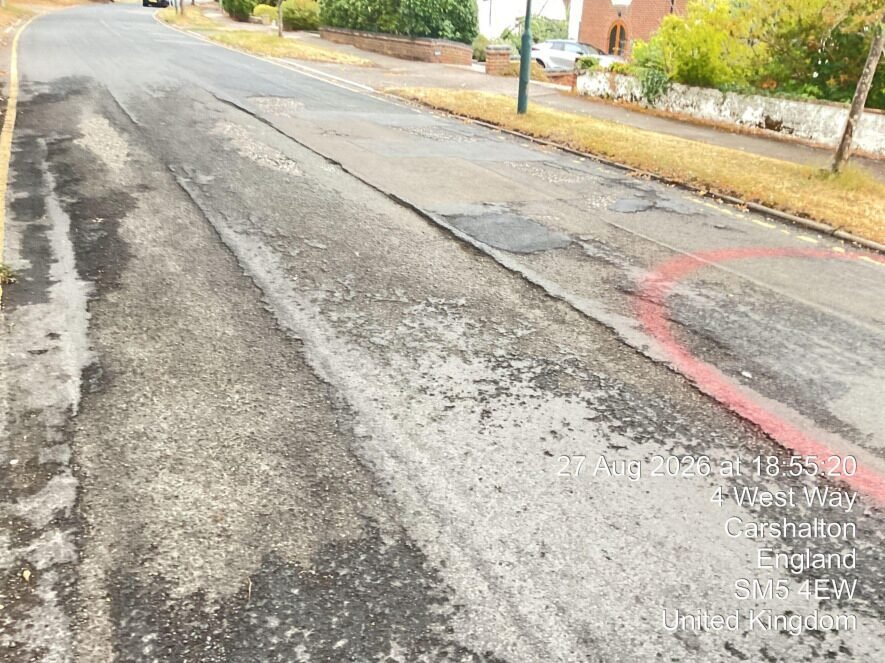

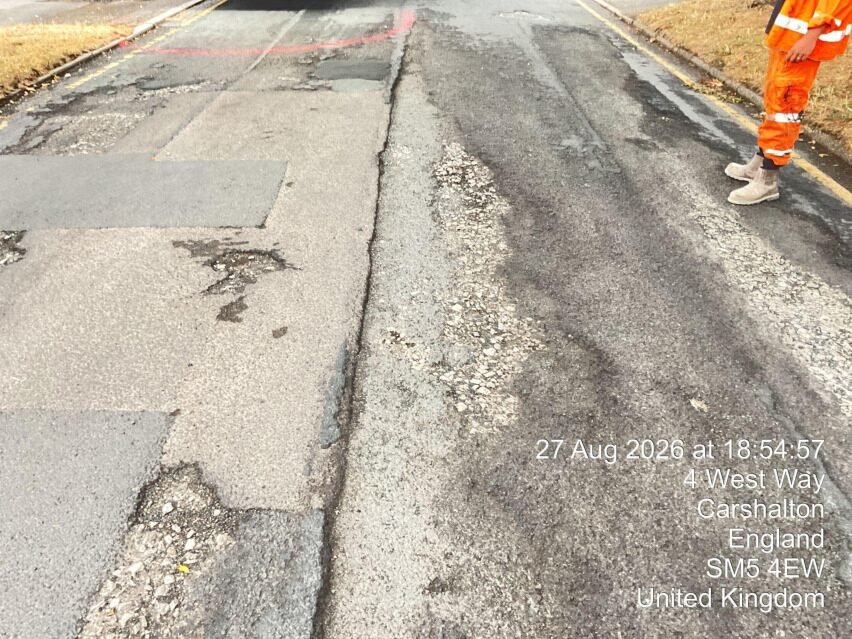

Before & Completed Works

The photographs below show the existing worn and patched carriageway before works and the completed Elastomac repair delivered during the overnight shift.

Why This West Way Road Repair Case Study Matters

West Way demonstrates a local authority carriageway repair completed in a single overnight working window, with worn surfacing, previous patching and localised defects repaired to leave a clean finished carriageway surface.

Full-width repair in one shift

Elastomac’s rapid cure allowed the team to switch traffic management from one side of the carriageway to the other, completing the full-width repair in a single night. This avoided a second TM setup and kept disruption to a minimum, with repaired areas trafficable in approximately 10 minutes.

Elastomac Highway Repair in Sutton

For more information about the repair system used at West Way, visit the Elastomac service page, explore more highway maintenance case studies, or contact Platinum 3Sixty to discuss a carriageway repair requirement.

Full West Way Case Study PDF

View the complete two-page project case study below, including the project snapshot, before-and-after photographs and the one-night delivery approach.

© 2026 Platinum 3Sixty Ltd | All Rights Reserved
